FNS_SDLC_Guide 12 24 2013x FNS SDLC Guide

User Manual:

Open the PDF directly: View PDF PDF.
Page Count: 37

United States Department of Agriculture
Food and Nutrition Service
Office of Information Technology
Portfolio Management Division (PMD)
SystemsDevelopmentLifecycleGuide
(SDLCGuide)
September12,2012
SDLC Guide
SDLC Guide September 12, 2012 Page 2
RevisionHistory
Version Date Author Change Description
1.0 09-12-2012 Catherine Howard Created the document
1.1 02-25-2013 Syed Jaffery Updated deliverable list and added
modular/iterative development information.
1.2 03-08-2013 Kevin Russ Updated figure 1 and added stakeholders
1.3 11-06-2013 Kevin Russ Updated Deliverable list and footnotes.
1.4 12-24-2013 Panum Group Updated SDLC High-Level Governance
Diagram
ContactInformation
Area of Concern Contact Person
IT Governance Lead Kevin Russ
SDLC Coordinator Syed Jaffery
ITIRB Coordinator Sunny Dilawari
Portfolio Manager Jacqueline Butler
Program (Project) Management Branch Allison Willcox
SDLC Guide
SDLC Guide March 6, 2013 Page 3
Contents
I.Purpose and Scope ................................................................................................................................. 4
II.SDLC Overview ....................................................................................................................................... 4
Phase 1: Initiation ...................................................................................................................................... 9
Phase 2: Requirements Gathering and Analysis ..................................................................................... 10
Phase 3: Design ...................................................................................................................................... 11
Phase 4: Development ............................................................................................................................ 12
Phase 5: Integration & Testing ................................................................................................................ 13
Phase 6: Implementation ......................................................................................................................... 14
Phase 7: Operations / Maintenance (O&M) ............................................................................................. 15
Phase 8: Disposition ................................................................................................................................ 16
III.Controls / Assumptions ......................................................................................................................... 17
IV.Documentation ...................................................................................................................................... 17
V.Appendix ............................................................................................................................................... 17
A.System Category – Project Sizes ................................................................................................ 17
B.Phase Requirements ................................................................................................................... 17
C.Large Project Process Flow - Example ........................................................................................ 17
D.Phase Gate Reviews ................................................................................................................... 17
E.Stakeholders – Defined ............................................................................................................... 17
F.Working Group Charter ................................................................................................................ 17
G.Executive Group Charter ............................................................................................................. 17
SDLC Guide
SDLC Guide March 6, 2013 Page 4
I. PurposeandScope
This document details USDA FNS’ systems development lifecycle (SDLC). This process is used for all
USDA FNS OIT projects related to information system and application development, developed either
contractually or in-house. The SDLC is applicable across all FNS environments (e.g., workstation, server,
mobile, etc.).
The SDLC is used in conjunction with policy and guidelines for the security SDLC, records management,
and, acquisition and procurement. It is important to note that no system can go live unless it goes through
the security accreditation process. Further, while all Phases of the SDLC are applicable to all software
development projects, the specific steps, participants, and reviews and approvals vary depending upon
project size (as a function of cost). Information on project size as a determinant of SDLC project
categorization is detailed in Appendix A.
II. SDLCOverview
The SDLC guides the process for custom software development projects and requires various documents
and deliverables for each Phase. The system development lifecycle is the IT business process by which the
delivery Phases of custom software development projects is conducted. The SDLC provides a structure
and set of governance for FNS software development efforts. The SDLC provides the guidance required to
ensure predictability and consistency across software development projects There are eight Phases of the
SDLC, beginning with Initiation and ending with Disposition. Each successive Phase of the SDLC
leverages the documentation and knowledge gained from the previous Phases. The FNS SDLC framework
allows for tailoring of the process to include customizing, waiving or combining particular SDLC Phases,
activities, deliverables or project reviews based on your specific project requirements or specific business
needs. Tailoring is completed during the Initiation Phase of the project and is documented in the Project
Process Agreement. Project Managers document the reason why specific Phases, activities, deliverables
or reviews were adjusted. This tailoring approach is useful for iterative, incremental, modular and agile
type development methods. A graphical representation of the process is detailed in Figure 1.
SDLC Guide
SDLC Guide September 12, 2012 Page 5

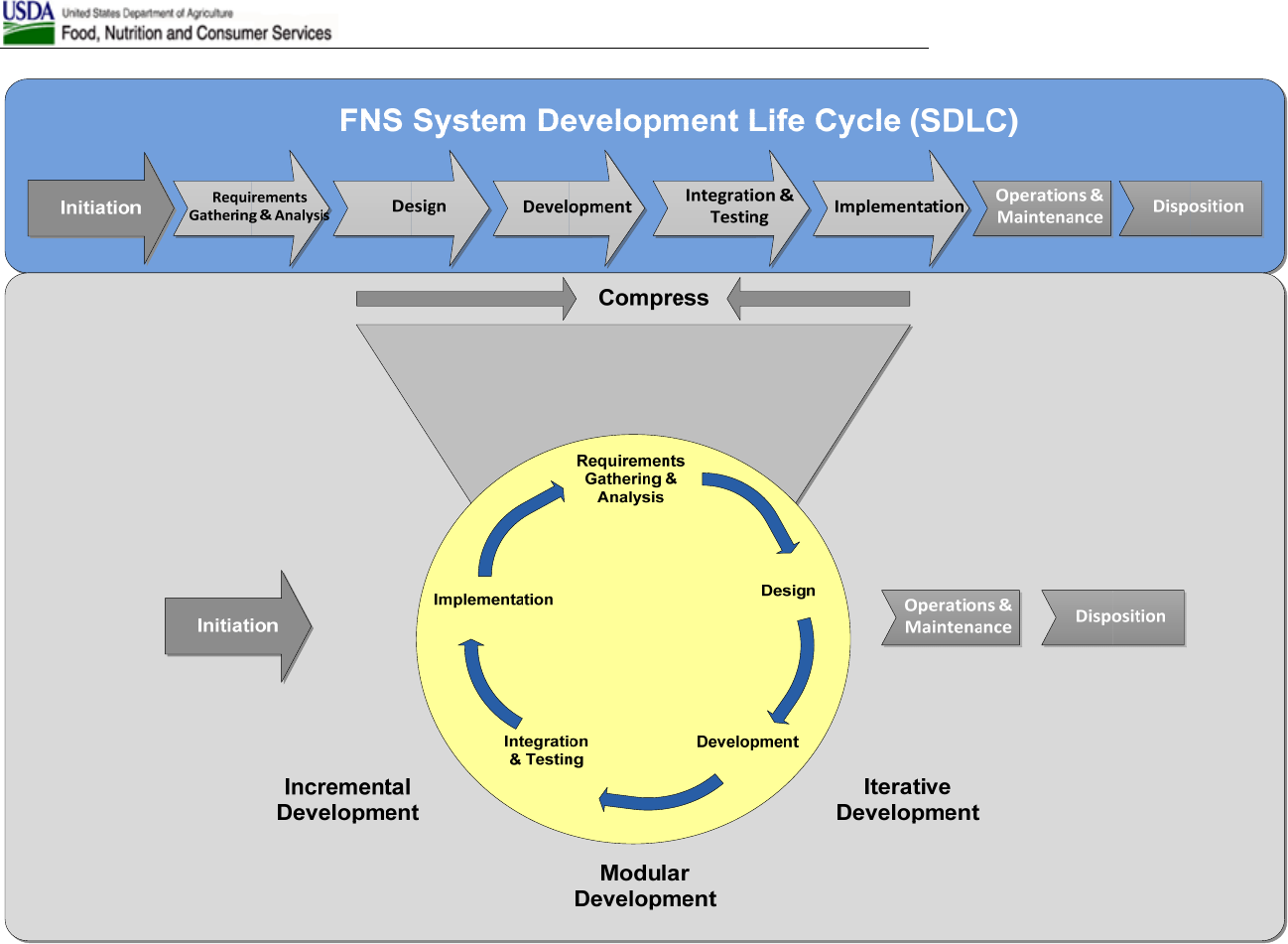

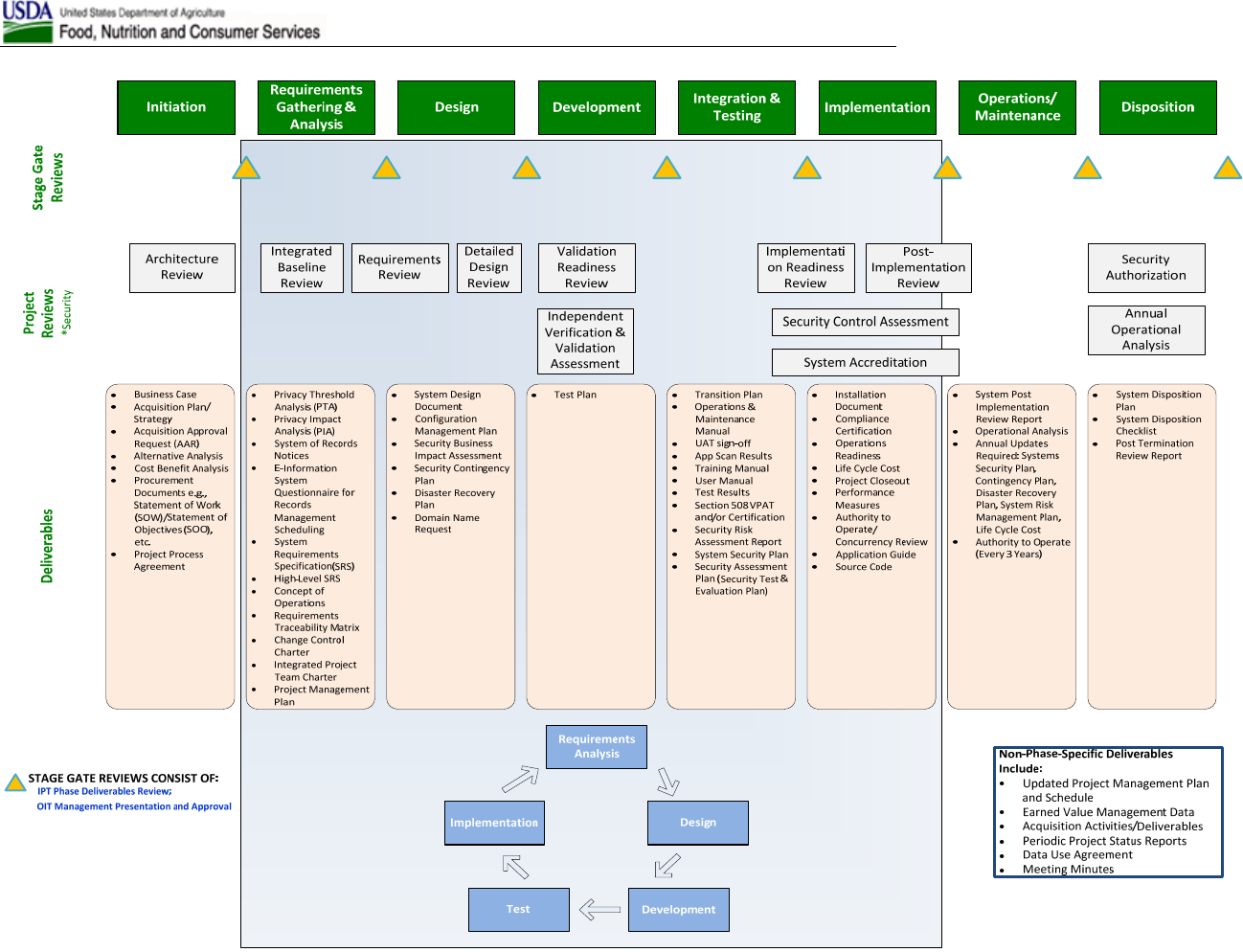

Figure 1. FNS SDLC Framework
SDLC Guide
SDLC Guide September 12, 2012 Page 6
The SDLC Phases serve as checkpoints for managing OIT projects from cradle to grave. Benefits of the
SDLC include:
Improved system integration and alignment to organizational objectives
Increased compliance with current and planned enterprise architecture
Improved assurance that systems are maintainable
Reduced system redundancies and improved cost-effectiveness
Reduced project “scope creep” through enhanced “up front” needs analysis
Improved method consistency, repeatability, flexibility, and transparency
Strengthened controls and accountability
Enhanced user, manager, and stakeholder involvement
The SDLC encompasses eight Phases: Initiation, Requirements Gathering and Analysis, Design,
Development, Integration and Testing, Implementation, Operations and Maintenance, and Disposition.
Required Phase deliverables, reviews, and approvals can differ depending upon project size1 and
stakeholders2 involved. A comprehensive list of all potential deliverables is detailed in the following table
shown in Figure 2. All deliverables are required for each Phase unless otherwise noted. Specific Phase
requirements by project size are detailed in Appendix B.
Figure 2. List of Deliverables
Phase Deliverables
*Exact deliverables differ depending upon project size criteria Development Notes
1. Initiation Business Case (FNS758; FNS755)
Project Management Plan (optional)3
Acquisition Plan / Strategy
Acquisition Approval Request
Alternative Analysis
Cost Benefit Analysis
Integrated Project Team Charter (optional)3
Project Process Agreement (optional)3
Privacy Threshold Analysis (PTA, optional)3
Privacy Impact Analysis (optional)
2. Requirements
Gathering and
Analysis
Privacy Threshold Analysis (PTA)
Privacy Impact Analysis (PIA)
System of Records Notices (SORN)
Electronic Information System Questionnaire for Records
Management Scheduling
Iterative Development
(Optional)
1 Project size is detailed in Appendix A
2 Stakeholders are defined in Appendix D
3 Optional during the initiation phase but required in the requirements gathering and analysis phase
SDLC Guide
SDLC Guide March 6, 2013 Page 7
Phase Deliverables
*Exact deliverables differ depending upon project size criteria Development Notes
System Requirements Specification (SRS)
Concept of Operations
Integrated Project Team Charter
Project Process Agreement
Project Management Plan
Requirements Traceability Matrix
3. Design Procurement Documents (e.g. Statement of Work (SOW) /
Performance Work Statement (PWS) / Statement of
Objectives (SOO))
System Design Document
Configuration Management Plan
Security Business Impact Assessment
Security Contingency Plan
Disaster Recovery Plan
Domain Name Request
4. Development Test Plan
5. Integration &
Testing
Transition Plan
Operations/Maintenance Manual
UAT sign-off
App Scan Results
Training Manual
User Manual
Test Results
Section 508 VPAT and/or Certification
Security Risk Assessment Report
System Security Plan
Security Assessment Plan (Security Test & Evaluation
Plan)
6. Implementation Installation Document
Compliance Certification
Operations Readiness
Life Cycle Cost
Project Closeout
Performance Measures
Authority to Operate/Concurrency Review
Application Guide
Source Code
7. Operations /
Maintenance
(O&M)
System Post Implementation Review Report
Operational Analysis
Annual Updates Required:
o Systems Security Plan
o Contingency Plan
o Disaster Recovery Plan
o System Risk Management Plan
o Life Cycle Cost
Authority to Operate (Every 3 Years)
SDLC Guide
SDLC Guide March 6, 2013 Page 8
Phase Deliverables
*Exact deliverables differ depending upon project size criteria Development Notes
8. Disposition System Disposition Plan
System Disposition Checklist
Post-Termination Review Report
SDLC Guide
SDLC Guide March 6, 2013 Page 9
Phase1:Initiation
The purpose of the Initiation Phase is to conduct initial assessment of a potential OIT system/application
development effort. This Phase helps establish a framework for project success, and includes establishing
processes for defining, planning, controlling and communicating about the project.
Deliverables4 in this Phase include:
Business Case (FNS758; FNS755)
Project Management Plan (optional)3
Acquisition Plan / Strategy
Acquisition Approval Request
Alternative Analysis
Cost Benefit Analysis
Integrated Project Team Charter (optional)3
Security and Privacy Document
Project Process Agreement
Privacy Impact Analysis (optional)3
Privacy Threshold Analysis (optional)3
Procurement Documents (e.g. Statement of Work (SOW) / Performance Work Statement (PWS) /
Statement of Objectives (SOO))
A critical governance body is established in this Phase: the Integrated Project Team (IPT). The IPT should
consist of the following core members: Project Lead; Developers; Business Leads; Technical
Representative; Security Representative; and COTR. Associate members should include Governance,
Network, Telecommunications, Records, O&M, and the Contracting Officer. The IPT is documented in this
Phase and functions from Initiation through the Implementation Phase.
The Initiation Phase includes activities, reviews and approvals as identified in the below flowchart.
4 A comprehensive deliverables list by project size is shown in Appendix B
3 Optional during the initiation phase but required in the requirements gathering and analysis phase
SDLC Guide
SDLC Guide March 6,
2013 Page
10

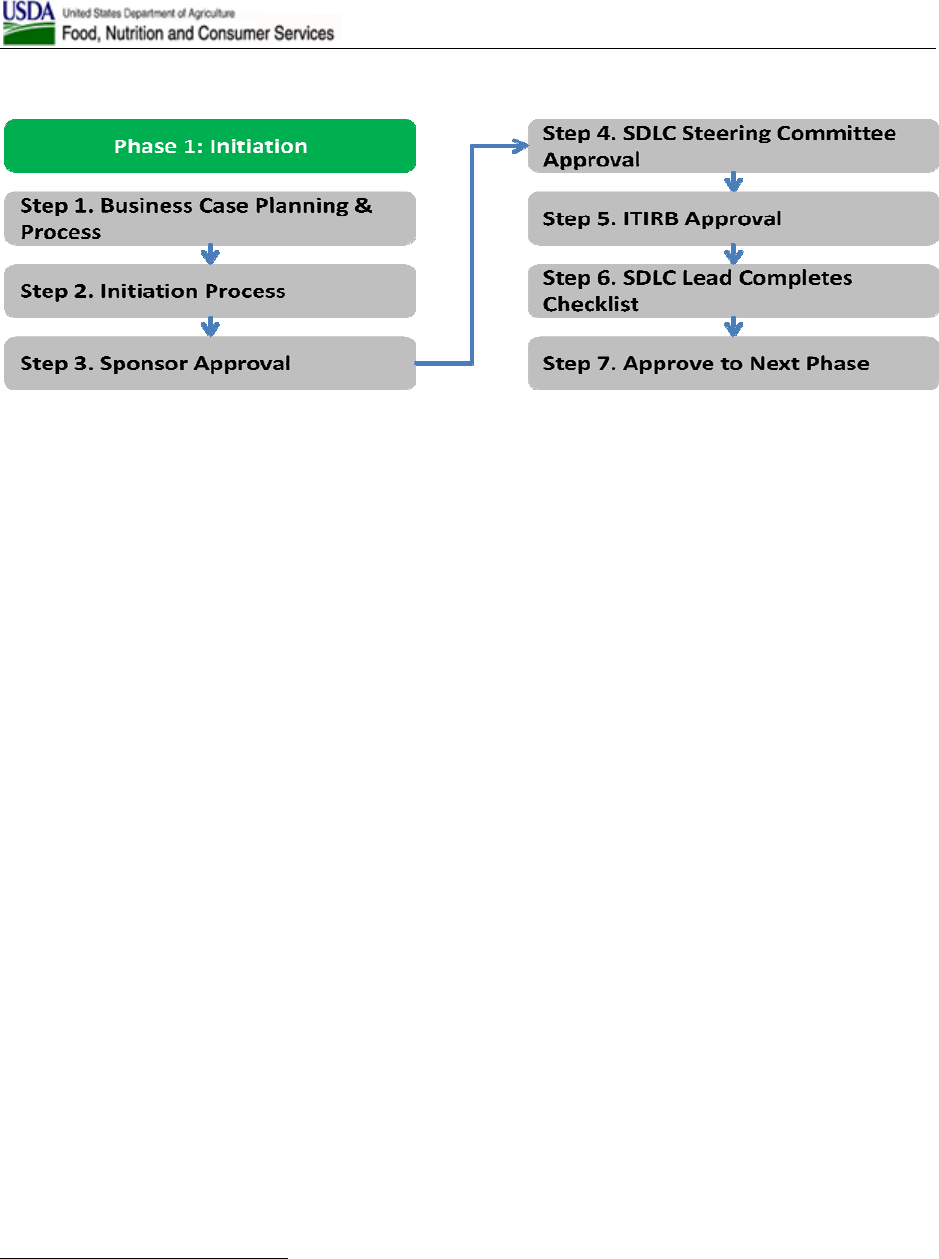

Figure 3. Initiation Phase Overview

Upon successful completion of the “Approve to Next Phase” step, the project progresses to the
Requirements Gathering and Analysis Phase.
Phase2:RequirementsGatheringandAnalysis
This Phase transforms the needs and high-level requirements specified in earlier Phases into unambiguous
(measurable and testable), traceable, complete, consistent, and stakeholder-approved requirements.
Defining requirements helps ensure development of the required capability on-time and within budget.
Deliverables
5
in this Phase include:
Privacy Threshold Analysis (PTA)
Privacy Impact Analysis (PIA)
System of Records Notices (SORN)
Electronic Information System Questionnaire for Records Management Scheduling
System Requirements Specification (SRS)
Concept of Operations
Requirements Traceability Matrix
Project Management Plan
Integrated Project Team Charter
Note: During this phase, some documents produced using “Agile” methodology may not be completed.
The Requirements Gathering and Analysis Phase undergoes activities, reviews and approvals as identified
in the below flowchart.
5
A comprehensive deliverables list by project size is shown in Appendix B
SDLC Guide
SDLC Guide March 6,
2013 Page
11

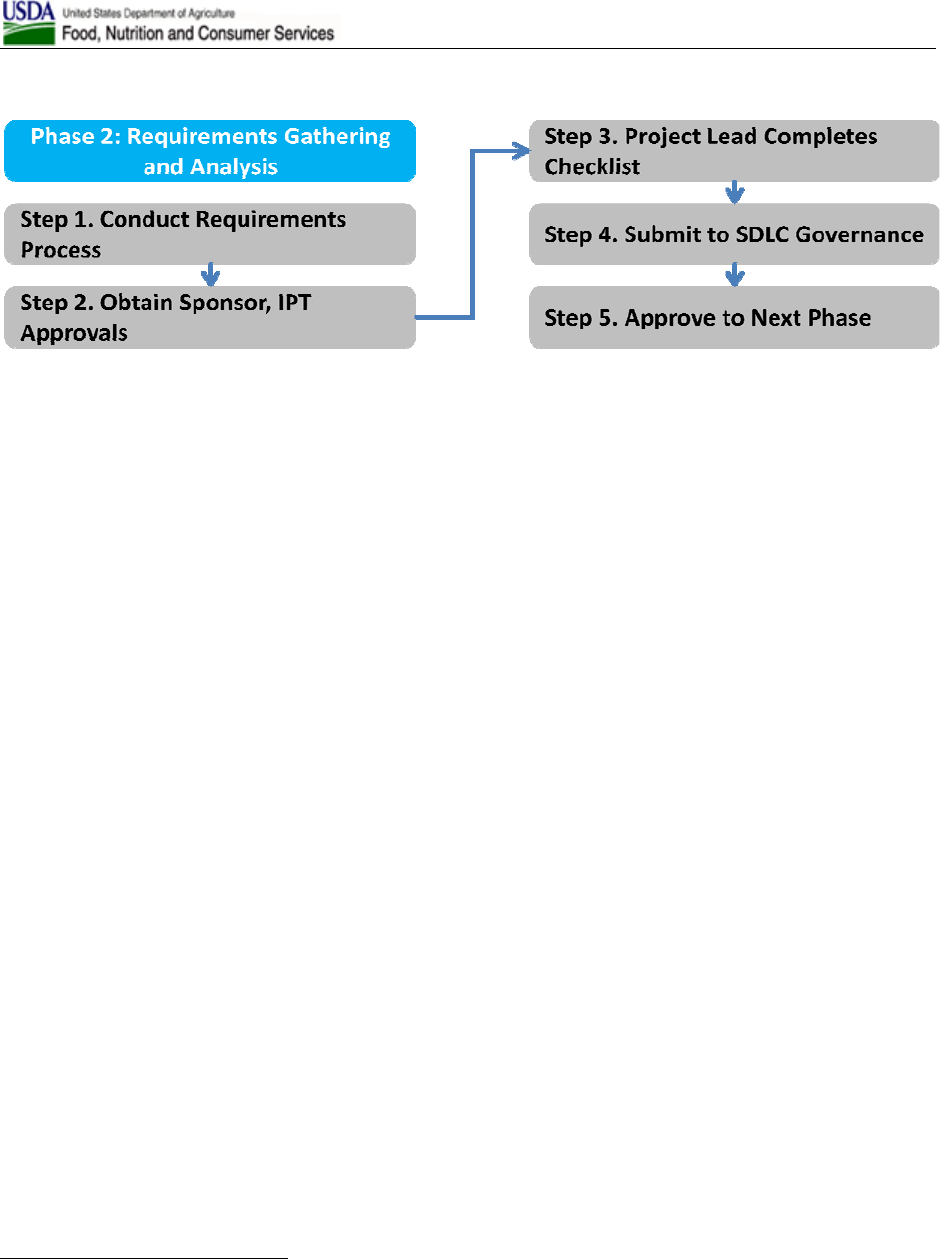

Figure 4. Requirements Gathering and Analysis Phase Overview
Upon successful completion of the “Approve to Next Phase” step, the project progresses to the Design
Phase.
Phase3:Design
The purpose of the Design Phase is to transform requirements into complete and detailed system design
specifications. The physical characteristics of the system are designed during this Phase, the operating
environment is established, major subsystems and their inputs and outputs are defined, and processes are
allocated to resources. The concept is further developed to describe how the business will operate once
the approved project is implemented (i.e. becomes a “system”), and to assess impact on employee and
customer privacy. Additionally, security authorization (formally known as certification and accreditation)
activities begin with the identification of security requirements and the completion of a high level
vulnerability assessment.
Deliverables
6
in this Phase include:
System Design Document
Configuration Management Plan
Security Business Impact Assessment
Security Contingency Plan
Disaster Recovery Plan
Domain Name Request
Note: During this phase, some documents produced using “Agile” methodology may not be completed.
The Design Phase undergoes activities, reviews and approvals as identified in the below flowchart.
6
A comprehensive deliverables list by project size is shown in Appendix B
SDLC Guide
SDLC Guide March 6,
2013 Page
12
Figure 5. Design Phase Overview
Upon successful completion of the “Approve to Next Phase” step, the project progresses to the
Development Phase.
Phase4:Development
The purpose of the Development Phase is to convert the system design prototyped in the Design Phase
into a working system that addresses all documented system requirements. Further, everything requiring
user input or approval must be documented in this Phase.
Deliverables
7
in this Phase include:
Test Plan
Note: During this phase, some documents produced using “Agile” methodology may not be completed.
The Development Phase undergoes activities, reviews and approvals as identified in the below flowchart.
Figure 6. Development Phase Overview
Upon successful completion of the “Approve to Next Phase” step, the project progresses to the Integration
& Testing Phase.
7
A comprehensive deliverables list by project size is shown in Appendix B
SDLC Guide
SDLC Guide March 6, 2013 Page 13
Phase5:Integration&Testing
The purpose of the Integration & Testing Phase is to lay the foundation for a smooth and successful
implementation. Key activities in this Phase include:
Attaining user input or approval as defined in the prior Phase (Development)
Preparing detailed logic specifications for each system module
Testing and integrating units into larger components
Preparing the technical environment for the system
This Phase focuses on achieving proof that the system meets all requirements, functions according to
design parameters, and satisfies all business, technical, and management stakeholders. Additionally, prior
to installing and operating the system in a production environment, the system must undergo security
authorization activities, as necessary.
Deliverables8 in this Phase include:
Transition Plan
Operations/Maintenance Manual
UAT sign-off
App Scan Results
Training Manual
User Manual
Test Results
Section 508 VPAT and/or Certification
Security Risk Assessment Report
System Security Plan
Security Assessment Plan (Security Test & Evaluation Plan)
Note: During this phase, some documents produced using “Agile” methodology may not be completed.
The Integration & Testing Phase undergoes activities, reviews and approvals as identified in the below
flowchart.
8 A comprehensive deliverables list by project size is shown in Appendix B
SDLC Guide
SDLC Guide March 6,
2013 Page
14

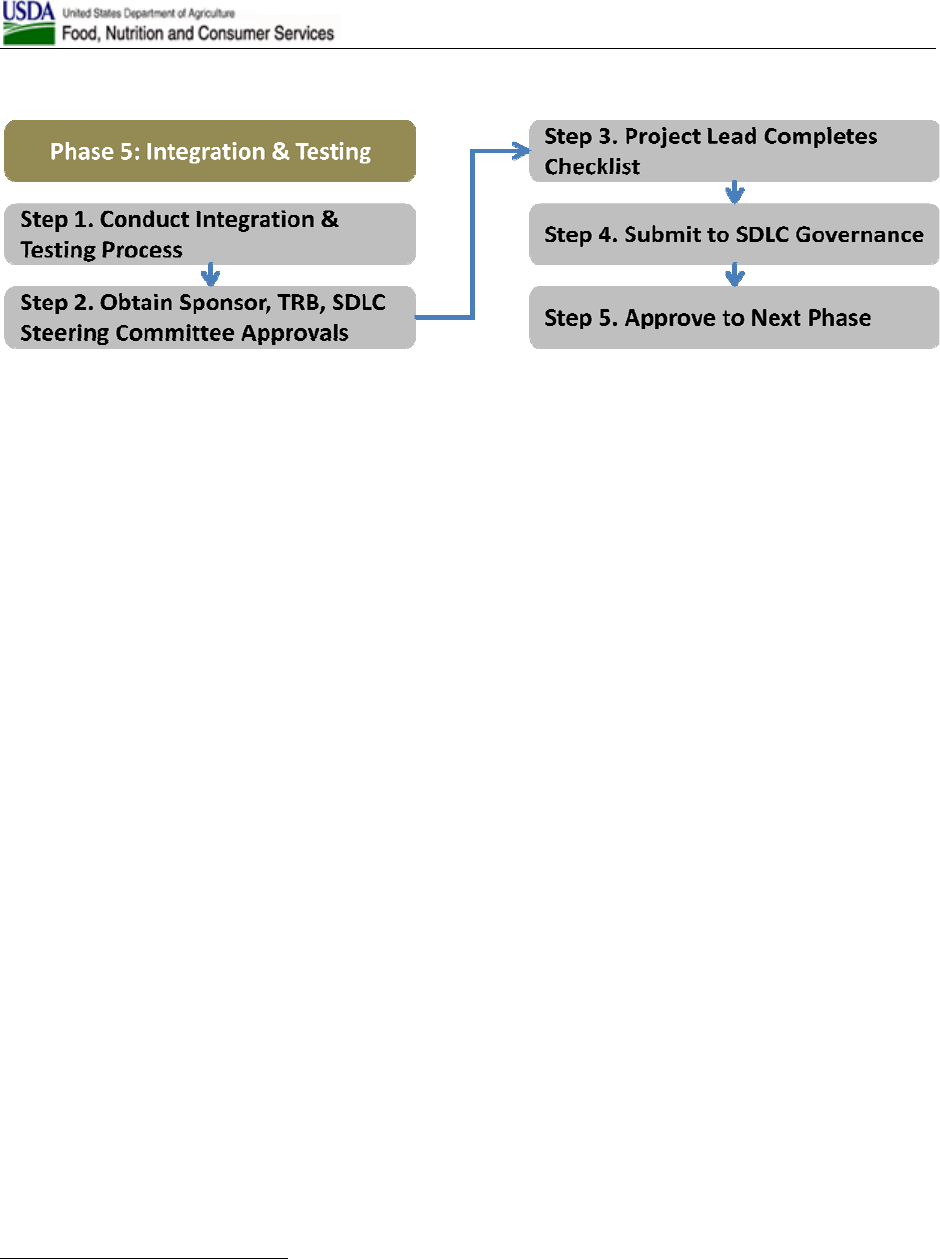

Figure 7. Integration & Testing Phase Overview
Upon successful completion of the “Approve to Next Phase” step, the project progresses to the
Implementation Phase.
Phase6:Implementation
The purpose of the Implementation Phase is to deploy and enable operations of the new information
system in the production environment. Successful completion of the Implementation Phase should
comprise both system deployment and training on the system.
Deliverables
9
in this Phase include:
Installation Document
Compliance Certification
Operations Readiness
Life Cycle Cost
Project Closeout
Performance Measures
Authority to Operate/Concurrency Review
Application Guide
Source Code
Note: All draft documents produced during previous phases for “Agile” projects must be completed during
this phase.
The Implementation Phase undergoes activities, reviews and approvals as identified in the below flowchart.
9
A comprehensive deliverables list by project size is shown in Appendix B
SDLC Guide
SDLC Guide March 6,
2013 Page
15
Figure 8. Implementation Phase Overview
Upon successful completion of the “Approve to Next Phase” step, the project progresses to the Operations
/ Maintenance (O&M) Phase.
Phase7:Operations/Maintenance(O&M)
The purpose of the Operations / Maintenance (O&M) Phase is to ensure the information system is fully
functional and performs optimally until the system reaches its end of life. The system is monitored for
continued performance in accordance with user requirements, and needed system modifications are
incorporated. The operational system is periodically assessed through In-Process Reviews to determine
how the system can be made more efficient and effective. Operations continue as long as the system can
be effectively adapted to respond to an organization’s needs. When modifications or changes are identified
as necessary, the system may reenter the planning Phase.
Deliverables
10
in this Phase include:
System Post Implementation Review Report
Operational Analysis
Annual Updates Required:
Systems Security Plan
Contingency Plan
Disaster Recovery Plan
System Risk Management Plan
Life Cycle Cost
Authority to Operate (Every 3 Years)
The O&M Phase undergoes activities, reviews and approvals as identified in the below flowchart.
10
A comprehensive deliverables list by project size is shown in Appendix B
SDLC Guide
SDLC Guide March 6,
2013 Page
16
Figure 9. Operations / Maintenance Phase Overview
Upon advancement to the “Continue in Phase or Retire” step, the project is determined to continue
operating or advance to the Disposition Phase.
Phase8:Disposition
The purpose of the Disposition Phase is to shut down the operational system in a controlled manner. The
disposition activities allow for the orderly termination of the system and preserve the vital information about
the system so that some or all of the information may be retrieved in the future, if necessary. Particular
emphasis is given to proper preservation of the data processed by the system, so that the data is effectively
migrated to another system or archived in accordance with applicable records management regulations and
policies for potential future access.
Deliverables
11
in this Phase include:
System Disposition Plan
System Disposition Checklist
Post-Termination Review Report
The Disposition Phase undergoes activities, reviews and approvals as identified in the below flowchart.
Figure 10. Disposition Phase Overview
11
A comprehensive deliverables list by project size is shown in Appendix B
SDLC Guide
SDLC Guide March 6, 2013 Page 17
Upon successful completion of the “Retire System / Application” step, the system is discontinued from
service.
III. Controls/Assumptions
This SDLC calls for a series of comprehensive management controls. These include:
Lifecycle management should be used to ensure a structured approach to information systems
development and operation.
Configuration management should occur in order to assist with reporting and decision-making.
Each project must have an accountable sponsor.
A single project manager must be appointed for each system project.
A comprehensive project management plan is required for each system project.
Data Management and security must be emphasized throughout the lifecycle.
A project may not proceed until resource availability is assured.
IV. Documentation
This lifecycle methodology specifies which documentation shall be generated during each Phase. Some
documentation remains unchanged throughout the systems lifecycle while others evolve or are revised to
reflect results from analyses performed in later Phases. Each of the documents produced are collected and
stored per OIT policy.
V. Appendix
A. System Category – Project Sizes
B. Phase Requirements
C. Large Project Process Flow - Example
D. Phase Gate Reviews
E. Stakeholders – Defined
F. Working Group Charter
G. Executive Group Charter
SDLC Guide
SDLC Guide March 6, 2013 Page 18
Appendix A: System Category – Project Sizes
Select from following categories to determine a project’s appropriate SDLC process:
i. Small Project
a. Expected cost is less than $25,000
b. Risk and complexity are low
c. An individual unit is involved
d. Expected duration is less than 4 months
ii. Medium Project
a. Expected cost is $25,000 to $500,000
b. Project Management methodology is required
c. Complexity is medium to high
d. Multiple people/departments are involved
e. Expected duration is less than a year
iii. Large Project
a. Expected cost is greater than $500,000
b. Full Project Management methodology is required
c. Expense, risk, or complexity are high
d. Large number of people/departments are involved
e. Anticipated lifecycle is long
SDLC Guide
SDLC Guide March 6, 2013 Page 19
Appendix B: Phase Requirements
Phase I - Initiation
Phase I - Initiation
Inputs N/A
Outputs /
Deliverables Outputs / Deliverables
Project Size
(Checkmark Denotes required)
Small Medium Large
Business Case: FNS758
Business Case: FNS755
Project Management Plan (optional)12
Acquisition Plan / Strategy
Acquisition Approval Request
Alternative Analysis
Cost Benefit Analysis
Integrated Project Team Charter
(optional)12
Procurement Documents, such as
Statement of Work (SOW)/
Performance Work Statement (PWS)
/ Statement of Objectives (SOO)
12 Optional during the initiation phase but required in the requirements gathering and analysis phase
SDLC Guide
SDLC Guide March 6, 2013 Page 20
Continuation: Initiation Phase
Outputs /
Deliverables Outputs / Deliverables
Project Size
(Checkmark Denotes required)
Small Medium Large
Project Process Agreement
Privacy Impact Analysis (Optional)13
Privacy Threshold Analysis
(Optional)13
Stakeholders Project Sponsor
Office of Information Technology Project Manager (OIT PM)
Subject Matter Experts (SME's)
Integrated Project Team(IPT)
13 Optional during the initiation phase but required in the requirements gathering and analysis phase
SDLC Guide
SDLC Guide March 6, 2013 Page 21
Phase II - Requirements Gathering and Analysis
Inputs Business Case
Project Plan
Outputs /
Deliverables Outputs / Deliverables
Project Size(Checkmark Denotes required)
Small Medium Large
Privacy Threshold Analysis (PTA)
Privacy Impact Analysis (PIA)
System of Records Notices (SORN)
Electronic Information System Questionnaire
for Records Management Scheduling
High-Level System Requirements
Specification (SRS)
System Requirements Specification (SRS)
Concept of Operations14
Requirements Traceability Matrix
Integrated Project Team Charter
Project Management Plan
Stakeholders Project Sponsor
SME's
Business Analyst
Integrated Project Team (IPT)
14 Concept of Operations is optional for large projects.
SDLC Guide
SDLC Guide March 6, 2013 Page 22
Phase II - Requirements Gathering and Analysis
OIT PM
SDLC Guide
SDLC Guide March 6, 2013 Page 23
Phase III - Design
Phase III - Design
Inputs Business Case
Project Plan
System Requirements Document (SRS)
Outputs /
Deliverables Outputs / Deliverables
Project Size
(Checkmark Denotes required)
Small Medium Large
System Design Document
Configuration Management Plan15
Security Business Impact Assessment16
Security Contingency Plan16
Disaster Recovery Plan
Domain Name Request
Stakeholders
Project Sponsor
SME's
OIT PM
Business Analyst
Network Managers
Developers
End Users
Integrated Project Team (IPT)
15 Configuration Management Plan is optional for small projects.
16 As required by Information Security Office(ISO)
SDLC Guide
SDLC Guide March 6, 2013 Page 24
Phase IV - Development
Phase IV - Development
Inputs System Requirements Document (SRS)
System Design Document
Outputs/
Deliverables Outputs/ Deliverables Project Size
(Checkmark Denotes required)
Small Medium Large
Test Plan
Stakeholders OIT PM
Business Analyst
Developers
Testers
Integrated Project Team (IPT)
SDLC Guide
SDLC Guide March 6, 2013 Page 25
Phase V – Integration and Testing
Phase V - Integration and Testing
Input System Requirements Document (SRS)
System Design Document
Project Plan
Test Plan
Outputs /
Deliverables Outputs / Deliverables
Project Size (Checkmark Denotes required)
Small Medium Large
Transition Plan
Operations/Maintenance Manual
UAT sign-off
App Scan Results
Training Manual
User Manual
Test Results
Section 508 VPAT and/or Certification
Security Risk Assessment Report17
System Security Plan17
Security Assessment Plan (Security Test &
Evaluation Plan)17
Stakeholders OIT PM
Business Analyst
Developers
SME's
OIT PM
Testers
Integrated Project Team (IPT)
17 As required by Information Security Office(ISO)
SDLC Guide
SDLC Guide March 6, 2013 Page 26
Phase VI – Implementation
Phase VI – Implementation
Inputs Project Plan
System Requirements Document (SRS)
System Design Document
Test Plan
Outputs /
Deliverables Outputs / Deliverables
Project Size
(Checkmark Denotes required)
Small Medium Large
Installation Document18
Compliance Certification
Operations Readiness
Lifecycle Cost
Project Closeout
Performance Measures
Authority to Operate/Concurrency
Review19
Application Guide20
Source Code
18 Installation document is optional for small projects.
19 As required by Information Security Office (ISO)
20 Application guide is optional for medium and large projects.
SDLC Guide
SDLC Guide March 6, 2013 Page 27
Phase VI – Implementation
Stakeholders OIT PM
Business Analyst
Project Sponsor
SME's
Network Managers
Developers
Contractors
Integrated Project Team (IPT)
IT Governance Branch (ITGB)
SDLC Guide
SDLC Guide March 6, 2013 Page 28
Phase VII – Operations/Maintenance
Phase VII – Operations/Maintenance
Inputs Project Plan
System Requirements Document (SRS)
System Design Document
Test Plan
Test Results
Installation Document
Application Guide
Outputs /
Deliverables Output / Deliverables
Project Size
(Checkmark Denotes required)
Small Medium Large
System Post Implementation Review Report
Operational Analysis
Annual Updates Required:
Systems Security Plan21
Contingency Plan21
Disaster Recovery Plan
System Risk Management Plan21
Lifecycle Cost
Authority to Operate (Every 3 Years)
Stakeholders
ITGB
O&MB
21 As required by Information Security Office(ISO)
SDLC Guide
SDLC Guide March 6, 2013 Page 29
Phase VIII – Disposition
Phase VIII – Disposition
Inputs Project Plan
System Requirements Document (SRS)
System Design Document
Test Plan
Test Results
Installation Document
Application Guide
Outputs /
Deliverables Outputs / Deliverables
Project Size
(Checkmark Denotes required)
Small Medium Large
System Disposition Plan
System Disposition Checklist
Post Termination Review Report
Stakeholders ITGB
O&MB
SDLC Guide
SDLC Guide March 6, 2013 Page 30
Appendix C –Project Process Flow - Example
FNS/OIT/PMD – SDLC Project Process Flow
IPTO&MB PMBVendor ITGB &
ITIRB
SDLC
Steering
Committee
ADB Customer
SDLC
Project
Manager/
Lead
Initiation, submit
Business Case
Categorize,
Review, and
Approve
Requirement
End
Business
Case
Processing
Maintain
(Ongoing)
Phase Review and
Checklist
Management
Integrated
Project Team
established
ITIRB
Approval?
Design and
Development
Oversight
Design and
Development
Keep
informed of
requirements
Integration
and Testing
Phase approval
and management
of process
Disposition
Yes
Contractor Support
Integration
and Testing
In house Decision to
retire system
No
SDLC Guide
SDLC Guide September 12, 2012 Page 31
Appendix D – Phase Gate Reviews
Phase Gate Reviews underlie the SDLC methodology from project management and governance
perspectives. The SDLC, divided into Phases, requires satisfying Phase Gate requirements (see Appendix
B for more detail) in order to advance along the lifecycle process. A high-level overview of the Phase Gate
Review process (i.e. High-Level SDLC Governance) is shown below.
SDLC Guide
SDLC Guide September 12, 2012 Page 32
SDLC Guide
SDLC Guide September 12, 2012 Page 33
Appendix E – Stakeholders Defined
Stakeholders will vary depending on project size and needs. The Project Lead plays a key role in
determining stakeholders. An overview of stakeholders that may be involved in the SDLC is listed below.
Business Analyst
Contractors
Developers
End Users
ICCB: Integrated Configuration Control Board
IPT: Integrated Project Team
ISO: Information Security Office
ITGB: IT Governance Branch
Network Managers
O&MB: Operations and Maintenance Branch
OIT PM: Office of Information Technology Project Manager
Project Sponsor
SDLC Steering Committee: PMD Managers
SME’s: Subject Matter Experts
Testers
TRB: Technical Review Board (OIT Managers)
SDLC Guide
SDLC Guide March 6, 2013 Page 34
Appendix F - Working Group Charter
Introduction
This document establishes the purpose, organizational structure, roles, responsibilities, activities, and
meeting expectations of the SDLC Working Group at the US Department of Agriculture (USDA) Food and
Nutrition Service (FNS), Office of Information Technology (OIT) Portfolio Management Division (PMD).
Purpose of the Working Group
The Working Group is the entity responsible for developing the SDLC framework and guidance at FNS.
The Working Group is critical to an effective SDLC in that it has the responsibility to: (1) create and finalize
the SDLC Phases and framework,; (2) determine the documentation required for each of the SDLC
Phases, (3) recommend the SDLC governance (gate reviews) and handoffs, and (4) recommend
improvements to the overall SDLC. An effective SDLC helps ensure the development of quality systems
that meet users needs in an efficient manner.
Organizational Structure of the Working Group
The SDLC Working Group consists of one member from each of PMD’s Branches and one member each
from the Technology Division and the Information Security Office. The composition of the Working Group is
subject to change to meet evolving organizational needs. The group functions in a collaborative, team-
oriented manner aimed to collectively overcome issues and make improvements to the SDLC. The table
below outlines the composition of the Working Group.
Organizational Role Working Group Role Responsibility
Application Development
Branch (ADB)
Working Group Member Advocate for ADB
Program Management
Branch (PMB)
Working Group Member Advocate for PMB
Operations & Maintenance
Branch (O&MB)
Working Group Member Advocate for O&MB
IT Governance Branch
(ITGB)
Working Group Member Advocate for ITGB
Technology Division (TD) Working Group Member Advocate for TD
Information Security Office
(IS)
Working Group Member Advocate for ISO
SDLC Program Manager* Guidance and Oversight Advocate for SDLC Governance
SDLC Guide
SDLC Guide March 6, 2013 Page 35
* The SDLC Program Manager is not an official, voting member of the Working Group but provides
guidance and oversight as the group deems necessary. The SDLC Program Manager has not yet been
appointed.
Activities of the Working Group
In support of achieving its objectives, the Working Group undertakes the following activities:
Objective Activities
1. Create SDLC framework Review and finalize SDLC Phases
Review and finalize SDLC framework,
including ISO, Acquisition and Records
Management integration.
2. Finalize SDLC documents Review framework and determine required
documents for SDLC Phase
Determine project/systems levels (small,
medium or large, etc)
Finalize required SDLC deliverables by
project level
Review SDLC templates and finalize
3. Recommend SDLC governance Determine SDLC Phase gate reviews,
including checklist for each of the
gate/Phase reviews
4. SDLC On-going Improvements Recommend improvement areas to
guidance, performance, standards and
procedures to the executive committee
Working Group Meeting Expectations
Regular touch-points are critical for Working Group success. The Working Group will meet bi-weekly
unless otherwise determined by the SDLC Program Manager or SDLC Lead. The Working Group will also
meet should urgent needs arise, as determined by the SDLC Program Manager or SDLC Lead. After
accomplishing objectives 1 – 3, the Working Group will meet on an ad-hoc basis.
SDLC Guide
SDLC Guide March 6, 2013 Page 36
Appendix G. Executive Group Charter
Introduction
This document establishes the purpose, organizational structure, roles, responsibilities, activities, and
meeting expectations of the SDLC Executive Committee at the US Department of Agriculture (USDA) Food
and Nutrition Service (FNS), Office of Information Technology (OIT) Portfolio Management Division (PMD).
Purpose of the Executive Committee
The Executive Committee is the entity responsible for SDLC stewardship at FNS. The Executive
Committee is critical to an effective SDLC in that it has the authority to: (1) oversee and make adjustments
the SDLC and CONOPS process / methodology; (2) oversee and adjust the SDLC supporting guidelines,
procedures, and standards; and (3) advocate the SDLC at FNS. An effective SDLC helps ensure the
development of quality systems that meet users needs in an efficient manner.
Organizational Structure of the Executive Committee
The SDLC Executive Committee consists of PMD’s Director, Branch Chiefs, and the SDLC Program
Manager. The composition of the Executive Committee is subject to change to meet evolving
organizational needs. The group functions in a collaborative, team-oriented manner aimed to collectively
overcome issues and make improvements to the SDLC and CONOPS. The table below outlines the
composition of the Executive Committee.
Organizational Role Executive Committee Role Responsibility
PMD Director Executive Committee Director Authority on final decisions
Application Development
Branch Chief
Executive Committee Member Advocate for ADB
Program Management
Branch Chief
Executive Committee Member Advocate for PMB
Operations & Maintenance
Branch Chief
Executive Committee Member Advocate for O&MB
IT Governance Branch
Chief
Executive Committee Member Advocate for ITGB
Activities of the Executive Committee
In support of achieving its objectives, the Executive Committee undertakes the following activities:
SDLC Guide
SDLC Guide March 6, 2013 Page 37
Objective Activities
Oversee and adjust the SDLC process /
methodology
Analyze SDLC performance measures
Determine SDLC issues
Identify issue prioritization and mitigation
strategies
Initiate performance improvement strategies
Define project management roles /
responsibilities, as needed
Review emerging trends and best practices
Refine SDLC goals, objectives and values,
as necessary
Update the SDLC, as needed
Communicate updates to external
stakeholders, as necessary
Oversee and adjust guidelines, procedures, and
standards
Assess needs related to guidance,
procedures, and standards
Authorize and modify SDLC guidelines,
procedures, and standards (such as Control
Gate materials), as needed
Advocate the SDLC at FNS Develop, implement, and monitor a SDLC
communications, learning, and knowledge-
sharing plan
Executive Committee Meeting Expectations
Regular touch-points are critical for Executive Committee success. The Executive Committee will meet
quarterly unless otherwise determined by the Executive Committee Director. The Executive Committee will
also meet should urgent needs arise, as determined by the Executive Committee Director.

Navigation menu
