Scrumban Simulation Facilitation Guide

User Manual:

Open the PDF directly: View PDF PDF.
Page Count: 18

SCRUMBAN
SIMULATION
Sangeetha Sridhar & Koen Vastmans
SIM
Facilitator guide
this page is intentionally left blank
Scrumban simulation
Table of Contents
Version history......................................................................................................................................2
Introduction..........................................................................................................................................3
What?....................................................................................................................................................4
The board..............................................................................................................................................4
Columns...........................................................................................................................................5
Limiting work in progress................................................................................................................6
The team...............................................................................................................................................6
The work to be done.............................................................................................................................7
Playing the game..................................................................................................................................8
Planning...........................................................................................................................................8
Iteration execution...........................................................................................................................8
First day of the iteration..............................................................................................................8
Last day of the iteration..............................................................................................................9
Other days...................................................................................................................................9
Four eyes principle...........................................................................................................................9
Evolving insight...............................................................................................................................9
Events.............................................................................................................................................10
Unplanned work.............................................................................................................................10
Retrospective.................................................................................................................................12
The next iteration................................................................................................................................12

Metrics................................................................................................................................................12
Value creation................................................................................................................................12
Cumulative flow diagram..............................................................................................................13
Cycle time versus lead time...........................................................................................................14
How can I win this?............................................................................................................................14
Needed materials................................................................................................................................15
License................................................................................................................................................16
Thank you!..........................................................................................................................................16
Scrumban simulation .1
Version history
Version Date Changes
0.1 2018-10-22 Initial draft version
0.2 2018-10-23 Added more info on the event
0.3 2018-10-27 Logo + pictures added
0.4 2018-10-28 Typos corrected
1.0 2018-11-07 Metrics paragraph added.
First final version after processing feedback from reviews
1.1 2018-12-02 New image of the value creation sheet
Introducing penalties for not completing unplanned work
1.2 2019-02-11 MoSCoW score taken into account for value creation (as a multiplier)
Penalty for not completing unplanned work modified
1.2.1 2019-02-27 Small correction in the reference to Okaloa Flowlab
Scrumban simulation .2
Introduction
This simulation came to existence because we needed a way to teach Scrumban.
As agile coaches we had been using the Kanban pizza game
(https://www.agile42.com/en/training/kanban-pizza-game/) for a while to teach
Kanban, but we needed the mix of both planned and unplanned work. And even
though the Pizza game is fun, not every participant is equally eager to learn by
coloring, cutting and pasting…
We know that there exist several similar simulations already. The No Estimates game
(https://mattphilip.wordpress.com/noestimates-game/) from Matthew Philip is one of the similar
games we know and tried in the past. Okaloa has a suite of simulations, the Okaloa Flowlab (http://
www.okaloa.com/flowlab). We never tried the Okaloa Flowlab ourselves. The basics of all these
simulations are the same: a Kanban board. Apart from that all other similarities are coincidental.
This is not intended as a copy or rip-off
of either of these simulations. Each
simulation has its own focus. This one
focuses on combining planned work
with unplanned work. But
coincidentally the NoEstimates game
happens to have a lot of common ideas
and features we were not aware of
when we started creating this
simulation. At least, when we got to
know the NoEstimates game, features
like events were not part of it yet. The aim of the Okaloa Flowlab is not to teach a certain process,
but to teach an agile mindset instead. Therefore it is a suite of simulations that help you to grow
from team level agility to organization wide strategic agility.
There is always room for improvement. The best way to discover that, is by doing the simulation.
(Mostly) Sangeetha and I did several tryouts before this simulation got into its first really usable and
shareable form. Now we have come to a point that others can benefit from our efforts too. We
certainly hope you enjoy doing this simulation as much as we enjoyed creating it.
If you have feedback, or improvements you want to share with us, please do so. You can find our
contact information on the last page, with the license information.
Sangeetha Sridhar & Koen Vastmans
November 2018 – February 2019
Scrumban simulation .3
What?
The Scrumban simulation is a game-like way to learn how to deal with both planned and unplanned
work. It is context-agnostic: there is no reference whatsoever to development, technology or
whatever, making this simulation suitable for both IT-development, IT-operations and non-IT
people.
The purpose of the game is to experience in a safe environment what the impact of unplanned
events is on your planning and work organization and how to deal with this unplanned work in
relation to your overall work.

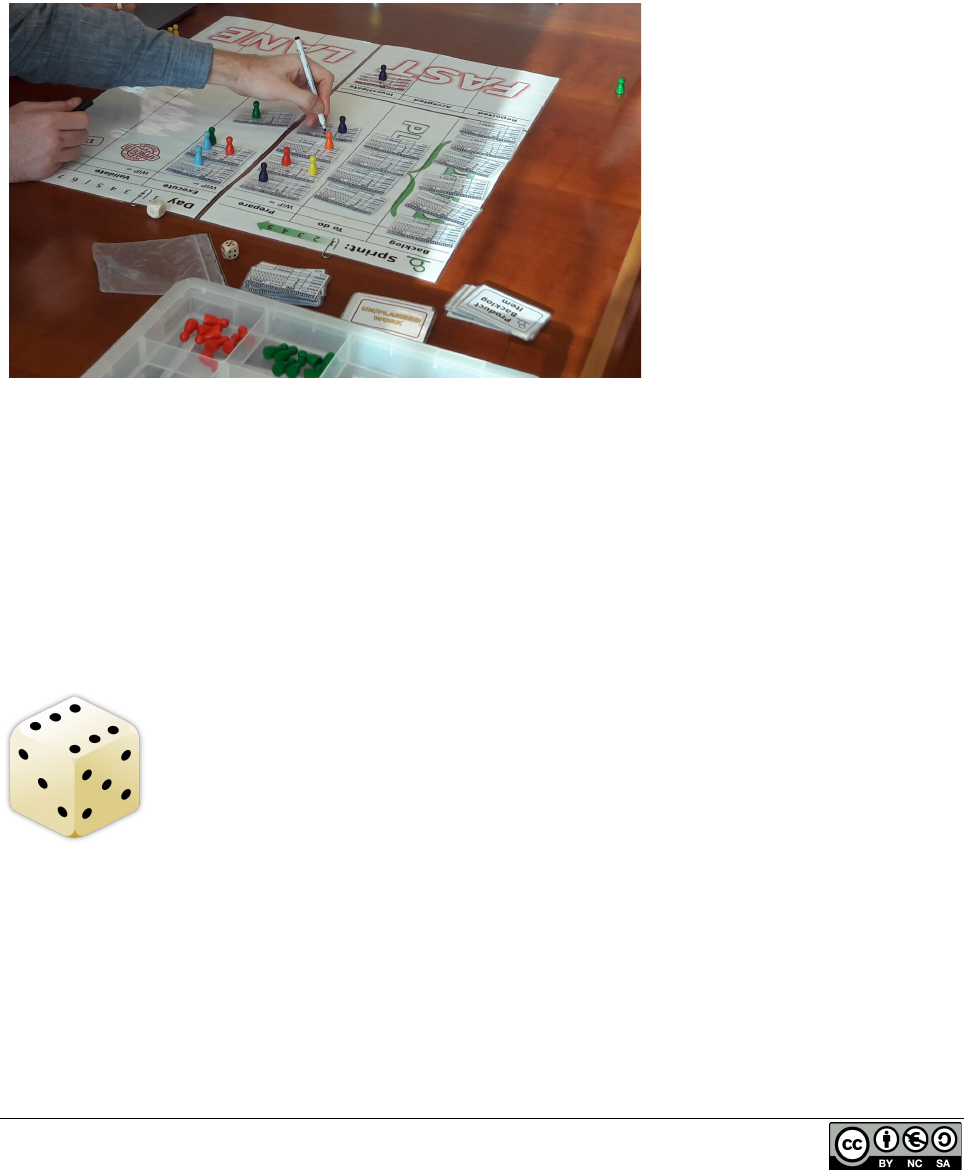

The board
This simulation can be played with 3 to 6 persons, of which 1 person takes the role of the product
owner, the one who decided on priorities.
In a normal work situation the team decides on the Kanban flow. In this simulation however, you
don’t have to spend time thinking about the best structure of your board. You simply get a
predefined board of which the majority is meant for the planned work and a fast lane is reserved for
taking care of unplanned work, incidents, for instance, if that is applicable in your context:
Scrumban simulation .4
Since this is a Scrumban simulation, you work with sprints, iterations. It is up to you whether you
choose to have sprints of 5 or of 10 days. Default – as indicated on the board – is 10 days.
You will need 2 paper clips here: 1 for indicating the sprint number and 1 for the day in the sprint.
Columns
The structure of the board is pretty straight forward. The planned part consists of the following
columns:
Backlog
This contains all the product backlog items that are not yet assigned to the current iteration,
ordered according to their priority
To do
This contains all the product backlog items that are planned for the current iteration and not
yet started
Prepare
This column contain the backlog items for which preparation work is started or done (since
we are dealing with a Kanban board, we don’t push these cards to the next column)
Execute
This column contains the backlog items that are being or have been implemented
Validate
After execution is done, some form of validation or testing needs to be done
Done
These are the columns of the fast lane:
Reported
All unplanned work starts in this column
Accepted
The team will do something for this unplanned work item – which means that is important
enough
Investigate
This is similar to the Prepare column in the top part of the board, but in case your inplanned
work are incidents, this is meant to check what is going on
Execute
The same as with planned work
Scrumban simulation .5
Validate
The same as with planned work
Done
The same as with planned work
There is no “Hold” column to park items. Instead items that are on hold during a certain stage are
marked as an impediment (see Evolving insight) for more information.
Limiting work in progress
There are 2 ways applicable to limit work in progress:
On the board you need to fill in the WiP (work in progress) limit for Prepare, Execute and
Validate statuses.
You fill in the WiP limits according to the number of people in the team that can execute
tasks in that status. Remember: stop starting, start finishing. Work in progress is considered
waste.
Each team member receives 3 pawns so that they can only execute at most 3
tasks at a time. Each time a team member picks up a task, he/she put one of
his/her pawns on the card. More than 1 team member can work on a task.
Whenever a task is done, the team member(s) can remove the pawn.
The team
A team consists of at least 2 team members plus a product owner. The product owner is the one that
decides about the priorities:
the order of the backlog item
which product backlog items should be implemented and which items not (yet)
what to do with unplanned work
There are 3 types of activities to be done:
preparation or (in case of unplanned work) investigation
execution
validation
The preparation and the validation work can be done by one type of role, whereas the execution is
more for another type of role. Similarly to a software development team where functional people
take care of the preparation and the validation, whereas the technical people take care of the
execution.
Scrumban simulation .6
This is not exclusive though: technical people can also do preparation and validation work and vice
versa, but at a cost: you can do 2 units of work that matches your role (e.g. technical person doing
execution work) but only 1 unit of work that does not match your role (e.g. a technical person doing
preparation). That is what T-shaped profiles – generalizing specialists – are about.
The work to be done
There are 2 types of work:
planned work – the product backlog items
unplanned work – they come at random
The units of work to be executed are indicated next to the names of the activities. These correspond
to the columns on the Kanban board. Notice that these units of work are on the left hand side of the
cell. This is because you need to be able to modify this value based on evolving insight. The small
circles next to the units of work are meant to indicate how many units have already been spent on
that activity.

The cells below the work estimations are meant to write down when – which iteration and which
day – the work item was planned or reported (for unplanned work), when someone started working
Scrumban simulation .7
on the work item and when it was done. This is especially useful to calculate the cycle time and the
lead time of the work item.
Playing the game
Planning
As already mentioned, the product owner has to
prioritize all work that has to be done. How he/she
decides about priorities is entirely his/her own
responsibility, but to help, the following criteria can
be considered (based on the information on the
product backlog cards):
MoSCoW scoring
Business value
Weighted Shortest Job First (WJSF – taking
into account the workload)
So the first thing the product owner has to do, is
ordering the entire product backlog and put the cards
(or at least a first set of most important backlog
items) in the Backlog column, ordered by priority.
Next, the team will pick cards from the backlog,
based on their capacity and what they think is
feasible to implement during the iteration. If they
don’t strictly follow the priorities of the product
owner – e.g. for capacity reasons – they have to
agree with the product owner. These cards are then
put in the Planned column. And now the fun can
really begin...
Iteration execution
First day of the iteration
During the first iteration you already spend half of your time on iteration planning, so you only have
half of your time left to work on the first day of the iteration. In practice, this means that you can
only color 1 dot in your own specialty. As a consequence, during the first sprint, since there is no
execution work yet, people dedicated to execution work cannot spend any time yet. Let’s assume
that they will spend that half day on reading documentation. The following sprints there will
probably still be loose ends to do or unplanned work to be finished.
Scrumban simulation .8
Last day of the iteration
Similarly, at the last day of the iteration, you can’t do any implementation work anymore. You
spend most of your time on meetings like retrospective and review meeting. In the context of this
simulation, there is nothing to review, but you will do a retrospective in order to improve your way
of working in the next iteration. No-one of the team will work on backlog items on the day of the
retrospective, but if there are any urgent unplanned items to finish, you can continue working on
these. After all, the world keeps spinning around…
Other days
Each player can put his/her pawn
on a card to execute a task.
Working on a task means filling
a circle next to the task. To
complete a task you have to fill
as many circles as indicated in

the workload cell next to it.
Don’t forget: you can work on a
task that is not your specialty but
only on half of the capacity as
working on a task of your
specialty. So a technical person
can do 2 units of execution work, but only 1 unit of preparation/investigation or validation work.
Four eyes principle
A team member that took care of the execution of a product backlog item or an unplanned work
item is not allowed to do the validation of the work him-/herself. Someone else in the team has to
do this. This is the four eyes principle.
Evolving insight
At the end of his/her round, when a task is done, a team member will not push the
card to the next stage. That is against the principles of Kanban: you pull cards. Even
if the task is done, you have to roll the dice. According to the value, you have to do
the following:
Scrumban simulation .9
1. add 1 unit of work to the last task you have worked on – even though it was finished
2. no action – lucky you
3. no action – lucky you
4. take an event card and act accordingly
5. block the last card you have been working on
You do this by putting a red pawn on the card
6. you can unblock any blocked card on the board
Events
The stack of event cards is placed face down. When you throw a 4 with the dice, you have to take
an event card. Some events only have impact on you as an individual, other events impact the entire
team. This can either be an impact on capacity – you or the team are confronted with an
unavailability – or on priority – someone decided that some backlog items are more important than
others. This is not only in a negative way, but also in a positive way. Some examples of events:
You are ill and are absent for
the rest of the week
Your Scrum master is ill and
you need to take over his role
for the rest of the week
You can finally go to that
training you wanted to attend
Another team is helping you
out with your unplanned work
Management intervention
makes that all impediments
are cleared
Some events have immediate impact
– or let’s say as of the next day
(because you pick up the card at the
end of your working day) – whereas some events will have an impact as of the next iteration.
Unplanned work
At the end of the day, someone of the team rolls this dice:
Scrumban simulation .10
A 0 means you’re lucky: no unplanned work pops up. Otherwise you have to take the number of
unplanned work cards from the stack as indicated on the dice:
Similar to the events, the stack of unplanned work cards is placed face down and you just pick cards
from the top of the stack.
Similarly to determining the priorities of the product backlog item, the product owner has to decide
about priorities of unplanned work. He/she can take this decision based on:
Priority
Workload
Unplanned work can e.g. be:
Executed ASAP
Planned in a next iteration
Postponed for a later stage
This all depends on the impact, both on the planned work and on the operational work. But
postponing unplanned work does not come without a penalty! Each day an unplanned work item did
not finish, you have to reduce your value creation (see further in Metrics), according to the priority
of the unplanned work item
1 for low priority work
5 for medium priority work
10 for high priority work
Scrumban simulation .11
Retrospective
At the end of each iteration the team does a retrospective. They will evaluate the way they worked
the past iteration, what went well, what could be done better. Some things to help you:
Were you able to finish what you had foreseen for this iteration? Didn’t you over-plan? Did
you create enough value?
How was the flow of work? Was there enough work prepared for execution ? Did the team
members assigned for execution have to assist in preparing items? What was the impact on
efficiency?
Did you take the right decisions on unplanned work?
Did you respect the WiP limits?
For more advanced teams:
How was your cycle time and lead time? What caused the longest cycle/lead time?
How does your cumulative flow diagram look like? Aren’t there too many open items?
Improve with small steps, don’t try to change everything at once, but focus on the improvement has
gives the biggest immediate impact in the next iteration.
The next iteration
After your retrospective you can start a new iteration. This is the right time to re-evaluate the
priorities of the remaining backlog items, see what to do with unplanned work that wasn’t accepted
yet and introduce the improvement(s) you agreed during the retrospective.
Metrics
If you are more advanced in Kanban and Scrumban, you can keep track of the following metrics:
Value creation
Cumulative flow diagram
Cycle time and lead time calculation
Value creation
The value creation is the simplest to keep track of. The value creation is the business value
multiplied by a factor based on the MoSCoW score of the product backlog item:
Must have: business value x 2
Should have: business value x 1
Could have: business value x 0,5
Won’t have: business value = 0
Scrumban simulation .12
There is a separate document template available for the business value calculation:
The usage of this document is very simple: day after day you write down how many value has been
created or lost (for unplanned work), per iteration and a total per iteration.
Cumulative flow diagram
The cumulative flow diagram gives a day to day visualization of the quantity of work at each stage.
It is called cumulative, because the graphs per stage are stacked. In an ideal situation, the graph for
planned work timeboxed in an iteration looks something like this:
In this fictitious example, at
the start of the iteration all
items are open. After 1 day of
working you see 3 item being
pulled, being prepared.
Typically at the start of an
iteration the focus is on
getting execution started as
quickly as possible, so in the
beginning you pull more
work into preparation. Then
the execution starts at day 2.
On day 3 people can start
validating items. And as of
day 4 the first item gets
Scrumban simulation .13
validated and done. The team continues pulling items. At day 7 all the preparation work is done. As
of day 8 the focus is entirely on validating. And on day 10 all the scope of the iteration is properly
done.
Off course in reality this graph will probably be more spiky, especially in a Scrumban context,
where also unplanned items need to be pulled in. And most likely not all items will be done at the
end of the iteration.
There is also a separate template available for the cumulative flow diagram, if you want to visualize
the work at all stages for your team.
Cycle time versus lead time
Lead time is the amount of time it takes between the request and the final delivery of an item. Cycle
time is the amount of time it takes from start of work until it is done.
On the cards of both the product backlog items and the unplanned work items there are boxes to
write down:
Planned work Unplanned work
iteration number and day when the item got planned/reported (in case of unplanned work)
iteration number and day when the work started
iteration number and day when the item was done
These numbers can then be used to calculate the cycle time and the lead time. The difference
between cycle time and lead time tells you something about efficiency of the flow: the closer the
cycle time is to the lead time, the better the flow. You can also compare these values with the total
workload to get an idea about your cost of delay.
How can I win this?
That is a question I was asked already several times… You know, if you play Flight Simulator, you
“win” if you can properly take off and land the plane without crashing. This is a simulation: you
win if you can improve your planning and take the right decisions to create value and handle
unplanned work.
But if you really want to introduce a game aspect? Then you would need at least 2 teams and keep
track of who creates the most business value and/or whose cumulative flow diagram show the best
balance between open, in progress and done items.
Scrumban simulation .14
Needed materials
The board, the cards and all the reference material are available for download. The board consists of
2 sheets of size A3 for the planned work and 2 sheets of size A4 for the fast lane. For durability and
re-usability it is better to laminate these sheets and stick them together with tape in such a way that
you can still fold the board to a single size A3 page.
The cards are measured 5 cm high by 8 cm wide. Because you need to mark the progress dots and
correct the estimates if needed, you need to laminate these as well. Credit card size laminating
pouches are best fit for that (approximate size 5,4 cm by 8,6 cm).
You need pawns, any color you like, 3 per team member, to indicate what they are working on, plus
red pawns for marking the blocked items. You better foresee enough red pawns, e.g. 10 per team.
2 paperclips will do to mark the iteration and the day of the iteration.
A regular dice is needed for the evolving insight and the events. To introduce the unplanned work,
you will need an empty dice so that you can add the values 0, 1 and 2 yourself. Or you could go for
a digital version: download a dice app. Configurable dice usually aren’t for free though...
To write on the cards (re-estimating and indicating progress) and the board (for indicating the WiP
limits) you need some thin whiteboard markers or non-permanent markers.
Scrumban simulation .15
License
This Scrumban simulation is created by Sangeetha
Sridhar and Koen Vastmans based on an initial pre-
mature idea of Dave Janssens. It is licensed under
Create Commons Attribution-NonCommercial-
ShareAlike 4.0 International license. What this
license means, can be found on the website of Creative Commons:
https://creativecommons.org/licenses/by-nc-sa/4.0/
Sangeetha Sridhar: https://www.linkedin.com/in/sangeetha-sridhar-88b1b47/
Koen Vastmans: https://www.linkedin.com/in/koenvastmans/
Thank you!
A special thank you goes to the following people who gave suggestions to improve the simulation:
Chris Verlinden
Sheryar Malik
Andy Verbunt
Dominique Jacobs
We would also like to thank the people who reviewed this document and gave feedback:
Matthew Philip
Madhavan Elango
Davy Benoot
Nele Van Beveren
Dominique Jacobs
Patrick Steyaert
And off course to all the people who tried out this simulation and gave their feedback.
Scrumban simulation .16

Navigation menu
